How to Prepare Rebar Mill Crane Specifications for Steel Plant EPC Tender Documents


Content Quick Link

Key Takeaway: A Rebar Mill Crane Specification Must Match the Whole Steel Production Process

A crane specification for a rebar mill EPC project is not only a list of lifting capacity and dimensions. It is a technical document that connects steel production process, factory layout, material handling requirements, building structure, electrical system, and future maintenance work.

Many EPC contractors face the same situation. The rolling mill equipment is selected first. The crane comes later. Then problems appear.

  • The crane cannot reach some maintenance areas.
  • The runway beam needs reinforcement after construction.
  • The lifting height is too low for equipment replacement.
  • The selected crane duty class cannot handle continuous operation.
  • The electrical system does not match the plant power supply.

A well-prepared rebar mill crane specification should be completed during the EPC engineering stage. The main information should include mechanical data, electrical requirements, installation conditions, working environment, and safety requirements.

The goal is simple: the crane should fit the factory before it arrives at the site.steel rebar handling

Role of Overhead Cranes in a Rebar Mill Production Line

A rebar mill is a continuous steel production system. Steel billets enter the plant. They move through raw material storage, reheating furnace, rolling mill, cooling bed, finishing area, and finished product storage.

During this process, overhead cranes support daily material handling and maintenance work.

AreaCrane Application
Billet storage yardSteel billet lifting, stacking, and transportation
Furnace areaBillet loading support and maintenance handling
Rolling mill areaRoll change, motor lifting, equipment maintenance
Finishing lineRebar bundle movement
WorkshopMachine repair and spare parts handling
WarehouseLoading and unloading materials

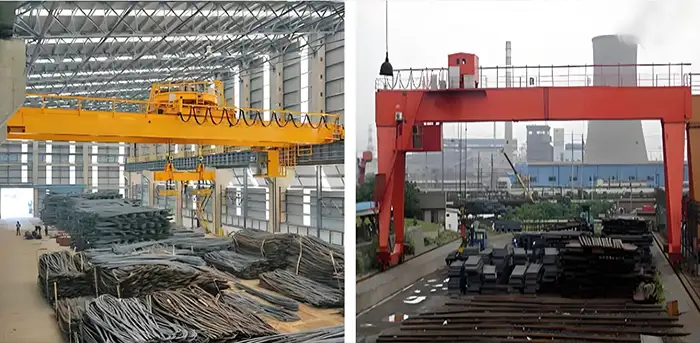

rebar handling cranes

How to Define Rebar Mill Crane Specification During EPC Design

Defining the right overhead crane for a steel rebar mill goes far beyond just knowing the lifting capacity. During the EPC (Engineering, Procurement, and Construction) phase, a well-specified crane is the backbone of operational efficiency. In this guide, we answer the essential engineering questions that ensure your crane supports material flow, maintenance, and long-term plant reliability.

1. What Will the Crane Lift? (Understanding Lifting Purpose & Load Capacity)

Before selecting a crane, you must identify every load it will encounter. This is the fundamental question that determines crane type, lifting accessories, and rated capacity. In a typical rebar mill, the crane handles steel billets from the storage yard to the furnace, finished rebar bundles after rolling, and heavy components like motors, gearboxes, and rolling mill stands during maintenance. Often, cranes used for daily production require a different duty classification than those used occasionally for heavy overhauls. Key takeaway: Always map out the complete material flow—from raw material handling to finished product storage—to ensure your crane's load capacity supports all operational scenarios.

2. How Often Will the Crane Work? (Duty Classification & Working Frequency)

It is a common mistake to select a crane based solely on its maximum lifting weight. The working frequency and operating cycle are critical for reliability and safety. You need to evaluate the number of lifts per shift, continuous production demands, peak production schedules, and maintenance lifting frequency. For instance, a crane operating continuously in the steel production area will need a higher duty classification (e.g., FEM or ISO standards) to ensure component longevity and reduce downtime. In simple terms, a crane for daily heavy use must be built with stronger mechanical and electrical components to handle the operating cycle and prevent premature fatigue.

3. Where Will the Crane Operate? (Environmental Factors & Protection Level)

The working environment is a major factor in crane design and component selection. In a rebar mill, conditions vary widely from indoor production workshops to outdoor storage yards, high-temperature zones near furnaces, and dusty environments with mill scale and steel particles. These conditions dictate the crane protection level, motor insulation class, electrical enclosure design, and even the need for special lifting attachments. Cranes operating in harsh dusty environments or high-heat areas require extra protection against corrosion and heat to ensure equipment reliability and safety. Ignoring the environment leads to rapid wear and costly component failures.

4. How Does Material Flow Impact EPC Crane Specifications?

During the EPC design phase, the crane cannot be specified in isolation. It must be designed according to the complete material flow and production process. This means analyzing the annual production capacity, the plant layout, and the specific crane operating areas. For example, if the material flow involves frequent shifting of billets, the crane's operating configuration must ensure fast and precise movement. Engineers must collect and verify key project data, including production targets and the process flow, to size the crane appropriately and prevent bottlenecks in the rolling mill production line.

5. What Maintenance Scenarios Affect Crane Specification?

One of the most overlooked aspects in crane specification is the maintenance requirement for the rolling mill equipment itself. The crane will be used to lift and replace heavy components like rolling stands, motors, and gearboxes during scheduled maintenance and unplanned shutdowns. This requires the crane to have adequate capacity and access to all machinery areas. For example, a maintenance crane might be used less frequently, but it needs to handle much heavier and bulkier loads than daily production cranes. The specification must consider both the lifting operation during normal production and these critical heavy-lift maintenance events.

6. How Does Workshop Structure & Runway Design Constrain Crane Selection?

Workshop structure and runway design are fundamental to crane feasibility. The crane dimensions, wheel loads, and clearance heights must match the available installation space. EPC engineers must consider the plant layout and the strength of the supporting structures before finalizing the crane's span and capacity. An ill-fitting crane can lead to costly structural modifications. Therefore, a comprehensive engineering analysis is crucial to ensure the crane system is optimized for the existing building constraints and future expansion plans.

7. Duty Classification vs. Max Load: Which is More Important?

While the maximum lifting load is a crucial figure, the duty classification is often more important for long-term reliability. The duty class defines the crane's ability to handle a specific number of work cycles at a given load. For instance, two cranes might both have a 20-ton capacity, but one might be rated for light (A1-A3) duty and the other for heavy (A6-A8) duty. The heavy-duty crane will feature more robust structural components, better motors, and more advanced control systems to handle continuous operation. Matching the duty class to the working frequency ensures the crane's lifecycle matches the steel mill's production demands.

8. What Special Features Are Needed for High-Temperature Crane Operation?

Operating cranes near furnaces or rolling lines exposes them to extreme high-temperature conditions. Standard electrical components can fail under thermal stress. In these zones, engineers must specify cranes with heat-resistant motor insulation, specialized electrical enclosures for heat dissipation, and thermal protection for the control system. Additionally, the control system configuration must be designed to allow operators to work safely from a distance. Using special lifting attachments designed for hot materials is also essential for operational efficiency and crew safety.

9. How Does Crane Specification Support the Plant's Entire Lifecycle?

A reliable rebar mill crane specification is not a simple list of dimensions and capacities; it is the result of a deep engineering analysis that considers production requirements, material flow, and maintenance scenarios. The goal is to support the steel mill lifecycle—from initial commissioning through peak production to future upgrades. By defining the crane based on actual plant operation, including both daily production loads and future maintenance requirements, EPC engineers ensure the crane system remains a valuable asset for decades, reducing downtime and total cost of ownership.

10. What Key Data Must EPC Tender Documents Include for Cranes?

Before preparing the EPC tender document, engineers must collect and verify critical project information. This includes the annual production capacity and material flow requirements, detailed plant layout and crane operating areas, the complete steel billet and rebar handling process, maximum lifting loads for both production and maintenance, crane working frequency, and the maintenance requirements for rolling mill equipment. The tender must also address the workshop structure, runway design, and available installation space to ensure accurate bids and a seamless installation process.

Mechanical Data Required for Rebar Mill Overhead Crane Design

Mechanical data defines the lifting performance, structural design, and service capability of a crane. For an EPC steel plant project, the crane specification should be prepared based on actual production requirements, maintenance scenarios, and future operating conditions.

Before finalizing the crane technical specification, EPC engineers should define the following mechanical design inputs:

Mechanical DataTypical SpecificationDesign Purpose
Crane Capacity5 ton - 100+ tonDetermine main structure, hoisting mechanism, and safety requirements
Crane Span10 m - 35 m (typical steel workshop range)Match building width and production equipment layout
Lifting Height6 m - 20 m+Ensure safe material handling and equipment maintenance clearance
Working DutyFEM 2M - 5M / ISO M5 - M8Define fatigue life and component selection
Travel DistanceAccording to workshop lengthDetermine runway system and power supply arrangement
Operating EnvironmentIndoor, outdoor, high temperature, dusty areaSelect protection level and special components

Crane Capacity Selection

Crane capacity is usually the first item defined in the EPC technical specification. It represents the maximum safe lifting load of the crane under designed operating conditions.

However, selecting crane capacity only according to daily production material is a common mistake. For rebar mills, engineers should evaluate both production handling loads and future maintenance loads throughout the plant lifecycle.

Typical crane capacity ranges in rebar mills depend on the application area:

Application AreaTypical Crane Capacity
Maintenance workshop5-20 Ton
Finished rebar bundle handling5-30 Ton
Rolling mill maintenance crane20-50 Ton
Billet handling crane30-100 Ton+

A rolling mill may normally handle steel billets and rebar bundles during daily operation. However, after several years of operation, major components may require replacement, including:

  • Main drive motors
  • Gearboxes
  • Rolling mill stands
  • Roll assemblies
  • Hydraulic cylinders
  • Cooling system components

Typical maintenance lifting loads may be significantly higher than normal production loads. For example:

EquipmentTypical Maintenance Weight Reference
Rolling mill motor2-30 Ton
Gearbox3-50 Ton
Roll assembly5-40 Ton
Hydraulic cylinder1-15 Ton

The crane capacity calculation should consider the total suspended load, including:

  • Hook block weight (normally 5%-15% of rated capacity depending on crane design)
  • Magnet weight
  • Coil clamp weight
  • Lifting beam weight
  • Special lifting tools
  • Maintenance lifting attachments

For example, a crane designed for 20 Ton equipment lifting may require a higher rated capacity if the lifting beam and attachments add several tons of additional suspended weight.

A reliable EPC specification should define the maximum lifting scenario, not only the normal production condition.

Crane Span and Factory Layout Coordination

The crane span is the center distance between the two runway rails. It determines the effective working coverage inside the workshop and directly affects material flow and maintenance accessibility.

Typical overhead crane spans in rebar production buildings are:

Workshop TypeTypical Crane Span
Maintenance workshop10-20 m
Production workshop20-35 m
Large steel plant bay35 m+

For rebar production plants, crane span selection should be coordinated with:

  • Rolling mill equipment arrangement
  • Billet storage area
  • Finishing and bundling area
  • Maintenance space
  • Material transportation route

During EPC design, engineers should verify:

  • Building column spacing (commonly 6-12 m depending on building design)
  • Runway beam location
  • Hook approach distance
  • Side clearance
  • Maximum equipment maintenance position

For example, if the crane span cannot cover the rolling mill maintenance area, additional mobile lifting equipment may be required. This increases maintenance time, equipment rental cost, and operational complexity.

Lifting Height Requirements

Lifting height defines the maximum vertical distance between the lowest hook position and the highest lifting position.

Typical lifting height requirements for rebar mill cranes include:

ApplicationTypical Lifting Height
Maintenance workshop crane6-10 m
Production handling crane8-15 m
Large steel plant crane15-25 m+

The required lifting height should consider:

  • Workshop building height
  • Equipment installation height
  • Motor and gearbox replacement requirements
  • Hook block dimensions
  • Safety clearance distance

For rolling mill maintenance applications, the lifting height must allow engineers to:

  • Remove old components from equipment foundations
  • Lift components above surrounding machines
  • Move loads safely to maintenance areas
  • Install replacement equipment accurately

Duty Class Selection for Steel Plant Cranes

Duty classification is one of the most important parameters for steel plant overhead crane design. It defines how frequently the crane operates, the number of working cycles, and the fatigue requirements of mechanical and structural components.

Two cranes with the same lifting capacity may require completely different designs.

For example, a 20-ton warehouse crane operating several times per day is different from a 20-ton billet handling crane operating every production shift.

Typical operating conditions:

ApplicationOperating ConditionTypical Duty Requirement
Maintenance workshop craneSeveral operations per weekFEM 2M-3M / ISO M5
Warehouse handling craneSeveral cycles per shiftFEM 2M-3M / ISO M5-M6
Billet handling craneContinuous production operationFEM 4M-5M / ISO M7
Rolling mill service craneFrequent heavy maintenance liftingFEM 4M-5M / ISO M7

Duty class affects:

  • Main girder fatigue design
  • Motor selection and service factor
  • Gearbox service life
  • Brake system reliability
  • Wheel and rail loading
  • Electrical component durability

Selecting the correct duty class helps prevent premature component failure and reduces unexpected production downtime.

Yuantai Cranes evaluates crane capacity, span, lifting height, and duty classification based on actual steel plant operation requirements. This approach helps EPC contractors select overhead cranes that can support both daily production and long-term maintenance needs.

Information Checklist for EPC Crane Tender Documents

A complete crane technical specification for an EPC project should provide sufficient engineering information for crane manufacturers to design, manufacture, and supply the correct lifting solution.

Missing technical data during the tender stage may cause problems during detailed engineering, such as crane redesign, building structure modification, electrical mismatch, or commissioning delays.

Mechanical Information

Mechanical information defines the crane configuration, lifting performance, and structural requirements.

Required InformationTypical Reference DataPurpose
Crane typeSingle Girder EOT Crane
Double Girder EOT Crane
Gantry Crane
Process Crane
Determine crane structure and application suitability
Crane quantity1-10+ units depending on plant layoutDefine production coverage and equipment allocation
Capacity5-20 Ton workshop cranes
20-50 Ton maintenance cranes
30-100 Ton billet handling cranes
Select hoisting mechanism and structural strength
Span10-35 m typical industrial rangeMatch building width and runway arrangement
Lifting height6-15 m typical
15 m+ for large steel plants
Ensure equipment installation and maintenance clearance
Duty classFEM 2M-3M for maintenance
FEM 4M-5M for steel production
Determine fatigue life and component selection
Hook typeSingle hook
Double hook
Special lifting attachment
Match lifting material and handling process
Lifting speed3-8 m/min standard lifting
Dual speed or VFD control for precise positioning
Control lifting efficiency and positioning accuracy
Traveling speedCrane travel: 20-40 m/min typical
Trolley travel: 10-30 m/min typical
Match production cycle and workshop size

Electrical Information

Electrical information ensures the crane system matches the factory power network and operating requirements.

Required InformationTypical Reference DataPurpose
Voltage380V
400V
415V
440V
Select motors, control panels, and electrical components
Frequency50Hz or 60HzMatch motor and inverter design
Phase3 Phase industrial power supplyDefine electrical system configuration
Control systemPendant control
Radio remote control
Cabin control
PLC + VFD control
Match operator requirements and automation level
Motor requirementsIP55 protection
Class F insulation
VFD compatible motors
Ensure reliable operation in industrial environments
Protection gradeIP54-IP65 depending on environmentProtect electrical components from dust and moisture
Safety devicesOverload limiter
Emergency stop
Limit switches
Anti-collision system
Improve operational safety

Installation Information

Installation requirements should be confirmed before crane manufacturing because the crane system is directly connected with the building structure and factory utilities.

Required InformationTypical Reference DataPurpose
Runway beam requirementsMaximum wheel load
Crane dead weight
Impact factor
Design supporting steel structure
Rail specificationQU70
QU80
QU100
Square rail or equivalent
Ensure smooth crane travel and reduce wheel wear
Power supply systemConductor bar
Festoon cable
Cable reel
Match crane travel distance and working environment
Installation conditionsIndoor / outdoor
Temperature range
Dust level
Altitude
Select suitable mechanical and electrical protection
Commissioning requirementsLoad test
Functional test
Electrical inspection
Verify crane performance before operation

Recommended EPC Tender Preparation Sequence

  1. Define lifting applications and material flow requirements
  2. Confirm crane capacity, span, lifting height, and duty class
  3. Collect electrical power system information
  4. Provide crane load data to building structure engineers
  5. Confirm runway, rail, and power supply arrangement
  6. Complete crane manufacturing, installation, testing, and commissioning

Yuantai Cranes supports EPC contractors by providing crane technical specifications, general arrangement drawings, wheel load information, and engineering data required for steel plant crane projects.

Common Mistakes in Steel Plant Crane Selection

Steel plant cranes are long-term production assets. A mistake made during the EPC design stage may affect daily operation, maintenance efficiency, and future expansion. The following are common crane selection mistakes found in steel plant projects.

Mistake 1: Choosing Crane Capacity Only From Production Data

Some projects select crane capacity only based on normal production materials, such as steel billets, rebar bundles, or finished products.

However, steel plants require cranes not only for production handling but also for equipment maintenance throughout the plant lifecycle.

A crane designed for a rebar mill should consider both:

  • Normal production lifting load
  • Maximum maintenance lifting load
  • Lifting attachment weight
  • Future equipment replacement requirements

For example, a rolling mill may normally handle 5-10 ton material loads during production. However, replacement of a main motor, gearbox, or rolling stand may require lifting 15-30 tons or more depending on equipment design.

The total crane load calculation should include:

Load ComponentTypical Consideration
Material loadSteel billet, rebar bundle, production equipment
Hook blockAdditional dead weight of lifting mechanism
Lifting beamUsually 0.5-5 ton depending on application
Magnet / clampAdditional lifting device weight
Maintenance equipmentMotor, gearbox, roll assembly, hydraulic components

The correct approach is to select crane capacity based on the maximum expected lifting scenario, not only current production conditions.

Mistake 2: Ignoring Crane Duty Classification

Crane capacity alone does not define crane performance. Duty classification determines how frequently the crane operates, how many lifting cycles it performs, and how much fatigue load the structure experiences.

A 20-ton crane in a warehouse and a 20-ton billet handling crane in a steel plant may have completely different designs.

ApplicationTypical OperationRecommended Duty Level
Maintenance craneSeveral lifting operations per weekFEM 2M-3M / ISO M5
Warehouse handling craneSeveral operations per shiftFEM 3M-4M / ISO M6
Billet handling craneContinuous production operationFEM 4M-5M / ISO M7
Steel mill process craneHigh-frequency repeated liftingFEM 5M+ / ISO M8

Duty classification affects:

  • Main girder fatigue life
  • Wheel and rail loading
  • Motor service factor
  • Gearbox lifetime
  • Brake system design
  • Electrical component selection

Selecting a lower duty class may reduce initial investment, but it can increase maintenance frequency and unplanned downtime during operation.

Mistake 3: Confirming Building Design Before Crane Data

This is a common coordination problem in EPC steel plant projects.

The workshop structure is sometimes designed before the final crane technical data is confirmed. Later, when the crane supplier provides actual wheel loads and runway requirements, the building structure may not meet the crane requirements.

Important crane data required for building design includes:

Crane DataPurpose
Maximum wheel loadDesign runway beam strength
Crane dead weightCalculate permanent structural load
Impact factorConsider dynamic operating load
Wheel quantity and arrangementDesign runway support points
Rail type and gaugeCoordinate crane and building interface

The recommended EPC design sequence is:

  1. Define crane application requirements
  2. Confirm crane capacity, span, duty class, and operating conditions
  3. Receive crane general arrangement drawing and wheel load data
  4. Design runway beams and supporting structures
  5. Finalize workshop steel structure
  6. Install and commission crane system

Early coordination between the EPC contractor, building designer, and crane manufacturer helps avoid structural modifications, schedule delays, and additional project costs.

Practical Checklist Before Ordering a Rebar Mill Crane

Before purchasing an overhead crane for a steel factory, EPC contractors and plant owners should confirm the following technical information. Providing accurate project data at the early stage helps avoid crane redesign, building modifications, and commissioning problems.

Load Requirements

The crane capacity should be based on the maximum expected lifting condition, including production handling and future maintenance requirements.

ItemInformation RequiredTypical Reference Value
Maximum lifting weightHighest load handled by crane5-10 Ton for workshop cranes
20-50 Ton for rolling mill cranes
50-100+ Ton for heavy steel plant applications
Maintenance loadWeight of replaceable equipmentMotor: 2-30 Ton
Gearbox: 3-50 Ton
Roll assembly: 5-40 Ton
Lifting tools weightHook block, magnet, clamp, lifting beam0.5-5 Ton additional load depending on application

The selected crane capacity should include all suspended loads, not only the production material weight.

Layout Requirements

The crane layout must match the factory building, production equipment arrangement, and maintenance access requirements.

ItemInformation RequiredTypical Reference Value
Crane spanDistance between runway rails10-35 m for typical industrial workshops
Travel distanceTotal crane runway length50-300 m depending on factory length
Hook coverage areaActual working area of lifting hookShould cover production line, storage area, and maintenance zones
Equipment clearanceDistance between hook path and machinesConsider equipment height, side clearance, and maintenance space

For example, a rolling mill workshop may require a crane span of approximately 25-35 m to cover the production line and maintenance area. Insufficient hook coverage may require additional mobile lifting equipment during future maintenance.

Operation Requirements

Operating conditions determine crane mechanical design, component selection, and service life.

ItemInformation RequiredTypical Reference Value
Duty classFrequency and intensity of crane operationFEM 2M-3M for maintenance
FEM 4M-5M for production cranes
Working hoursDaily operating time2-4 hours/day for maintenance
8-24 hours/day for continuous production
Control methodOperator control requirementPendant control
Radio remote control
Operator cabin control
PLC + VFD automation

For a rebar mill operating continuously, the crane design should consider frequent starts and stops, repeated lifting cycles, and long-term fatigue performance.

Engineering Requirements

The crane supplier and EPC contractor must coordinate building and electrical interfaces before manufacturing.

ItemRequired DataTypical Reference Value
Runway beam dataWheel load, crane weight, impact factorMaximum wheel load commonly ranges from 50 kN to 300+ kN depending on crane capacity
Rail systemRail type, size, gauge, fixing methodCommon crane rails: QU70, QU80, QU100 or equivalent
Power supplyVoltage, frequency, phase number380V/50Hz/3Ph
400V/50Hz/3Ph
415V/50Hz/3Ph
440V/60Hz/3Ph
Working environmentTemperature, dust, outdoor condition-20°C to +40°C standard industrial condition

A complete technical checklist allows EPC contractors, building designers, and crane manufacturers to define the correct crane solution before project execution.

Yuantai Cranes provides engineering support for rebar mill and steel plant crane projects, including crane selection, technical specification preparation, runway data coordination, and customized overhead crane solutions.

Videos of Steel Rebar Handling

Overhead Crane for Steel Rebar Handing, magnetic overhead crane for steel rebar handling, double hoist overhead cranes and spreader overhead cranes for long rebar handling

Gantry Crane for Steel Rebar Handing, 35 ton/10 ton gantry crane for steel rebar bundle handling , more typres of rebar handling, please feel free to contact us WhatsApp; + 86 150 38346929

FAQ: Rebar Mill Crane Specification for EPC Projects

1. What is included in a rebar mill crane specification?

A rebar mill crane specification should define all technical requirements required for engineering, manufacturing, installation, and commissioning. It normally includes mechanical data, electrical requirements, structural interface requirements, safety devices, and operating conditions.

For EPC steel plant projects, the specification usually includes:

  • Crane capacity and lifting purpose
  • Crane type and configuration
  • Span and lifting height
  • Working duty classification
  • Lifting and traveling speed
  • Power supply requirements
  • Control system
  • Runway beam and wheel load data
  • Environmental conditions

For example, Yuantai Cranes supplied overhead crane solutions for steel-related industries with specifications such as:

ParameterExample Specification
Crane TypeDouble Girder Overhead Crane
Capacity32 Ton
Span33 m
Lifting Height12 m
Duty ClassFEM 2M / ISO A5
Control ModeRadio Remote + Pendant Control
Power Supply440V / 60Hz / 3 Phase

A complete specification allows EPC contractors, crane manufacturers, and building designers to coordinate technical requirements before project execution.

2. How do EPC contractors select overhead cranes for steel plants?

EPC contractors should select steel plant cranes based on the complete production process rather than only lifting capacity.

The main evaluation factors include:

  • Material flow between production areas
  • Maximum production and maintenance loads
  • Crane working frequency
  • Workshop layout and runway conditions
  • Operating environment
  • Future expansion requirements

For example, a rebar mill may require different cranes for different areas:

Plant AreaTypical Crane ApplicationTypical Capacity Range
Billet storage yardBillet handling overhead crane20-75 Ton
Rolling mill areaProcess and maintenance crane10-50 Ton
Finishing areaRebar bundle handling crane5-20 Ton
Maintenance workshopGeneral EOT crane5-20 Ton

Experienced crane suppliers such as Yuantai Cranes can participate during the EPC engineering stage to help define suitable crane specifications according to actual plant operation requirements.

3. What type of crane is used in a rebar mill?

A modern rebar mill normally requires different overhead cranes for different material handling tasks.

Common crane applications include:

  • Billet Handling Overhead Crane: Used for moving steel billets from storage areas to furnace charging systems. These cranes usually require high duty classification because of frequent operation.
  • Rolling Mill Maintenance Crane: Used for lifting motors, gearboxes, roll assemblies, and hydraulic equipment during maintenance.
  • Workshop EOT Crane: Used for general maintenance and spare part handling.
  • Finished Product Handling Crane: Used for lifting and transporting bundled rebar products in storage and dispatch areas.

The crane configuration depends on the material weight, lifting frequency, working environment, and required positioning accuracy.

4. Why is duty class important for steel mill cranes?

Duty class is critical because steel plant cranes often operate under repeated loading conditions with high production frequency.

Two cranes with the same lifting capacity may have completely different service lives depending on their duty classification.

For example:

Crane ApplicationTypical Duty Class
Occasional maintenance liftingFEM 2M-3M
Regular workshop operationFEM 3M-4M
Billet and production handlingFEM 4M-5M
Continuous steel process operationFEM 5M+

Duty classification affects:

  • Main girder fatigue life
  • Motor and gearbox selection
  • Brake system reliability
  • Wheel loading
  • Maintenance frequency

Selecting the correct duty class helps ensure reliable crane operation throughout the steel plant lifecycle.

5. When should crane suppliers join an EPC project?

Crane suppliers should be involved during the engineering design stage, before finalizing building structures and equipment installation.

Early involvement helps EPC contractors confirm:

  • Crane capacity and configuration
  • Runway beam requirements
  • Maximum wheel loads
  • Power supply arrangement
  • Maintenance access requirements

For example, before designing a steel workshop structure, the EPC contractor should obtain crane technical data including:

Required DataPurpose
Crane dead weightStructural load calculation
Maximum wheel loadRunway beam design
Rail gaugeBuilding interface coordination
Power requirementElectrical system planning
Maintenance requirementsFactory operation planning

Yuantai Cranes works with EPC contractors during the engineering phase to provide crane technical data, general arrangement drawings, and customized lifting solutions for steel plant applications.

Conclusion: A Good Rebar Mill Crane Specification Starts With Factory Planning

A successful EPC steel plant project needs more than a crane supplier. It needs correct engineering coordination.

The rebar mill overhead crane should be selected based on production process, material flow, equipment maintenance, factory structure, and electrical system.

The most important step is preparing the crane specification early. When capacity, span, lifting height, duty class, and installation requirements are clearly defined, the crane can integrate smoothly into the rebar production line and support long-term plant operation.

Article by Bella ,who has been in the hoist and crane field since 2016. Bella provides overhead crane & gantry crane consultation services for clients who need a customized overhead travelling crane solution.Contact her to get free consultation.



Free consultation to Confirm Parameters & Specifications and Get

Latest Crane Price & Crane Rate.

  • Types of overhead cranes : _______?
  • Optional: Overhead travelling crane, goliath gantry crane,Slewing jib crane, Single girder or double girder crane,small portable crane or kbk crane, etc.
  • Capacity of overhead crane: _______?
  • Optional: 0.25ton, 0.5 ton, 1 ton, 2 ton, 3ton, 5 ton, 10 ton,15ton, 20ton, 25 ton, 30ton,35ton, up to 550ton, etc.
  • Crane span & lifting height : _______?
  • Crane travelling length : _____?
  • Control of overhead crane:_______?
  • Optional: pendant/ remote/cabin control
  • Voltage supply of overhead crane:_____?
  • Eg,: 380V50/60HZ,3Phase or others,etc.
  • Application/usage of crane:_______?
  • Eg,: Steel mill, ,injection mold, cement,stone, concrete,granite, general manufacturing, etc.
  • Just leave a message via the contact form and our hoist and crane engineer will contact you with in 24working hours.

Get In Touch

Feel Free
to Contact With us
